Romanian Motorways and Expressways Review - Q2 2025

(c) 130km.ro / 01 July 2025

Q2 was a busy period for Romanian high-speed road infrastructure. First, two new motorway routes were opened during this period:

Opening dateSectionStatusLength (km)
Jun 2025A1: Sibiu - Pitesti Section 5 (Curtea de Arges - Baiculesti)Open14.6
Jun 2025A0: Bucharest Ringroad South Section 3 (DN6 - A1/DJ601)Open18.0
Total length of sections opened in Q2 202532.6KM

Next, contracts were signed for execution of five new motorway and expressway sections in Q2:

Signing dateSectionStatusLength (km)
Apr 2025A3: Mihaiesti - Suplacu de Barcau section 3B3 (Poarta Salajului - Zalau)Under construction15.1
Apr 2025A3: Mihaiesti - Suplacu de Barcau section 3B4 (Zalau - Nusfalau)Under construction25.8
Apr 2025A8: Miercurea Nirajului - Leghin section 2c (Pipirig - Vanatori Neamt/Leghin)Under construction19.3
May 2025DEx16: Arad - Oradea section 1 (Oradea - Salonta)Under construction33.7
May 2025A8: Miercurea Nirajului - Leghin section 1b (Miercurea Nirajului - Sarateni)Under construction23.4
Total length of contracts signed in Q2 2025117.4KM

New tenders were launched for motorway sections in Q2 2025:

Tender dateSectionStatusLength (km)
May 2025A8: Targu Neamt - Ungheni section 3 (Letcani/DN28 - Iasi/DN24)Tender in progress17.7
May 2025A8: Targu Neamt - Ungheni section 4 (Iasi/DN24 - Golaiesti)Tender in progress12.7
May 2025A8: Targu Neamt - Ungheni section 5 (Golaiesti - Border/Ungheni Bridge)Tender in progress2.8
Total length of new tenders launched in Q1 202555.6KM

The status of all Romanian motorways and expressways which are open, are under construction or are tendered is presented below.

A0 MOTORWAY (Bucharest Ringroad)

The Southern section of the motorway is opened on its entire length (A2 - A1/DJ601, 51.2km) following the opening of section 3 in June 2025. On the Northern part of the motorway the status is as follows: section 1 (DJ601 – DN1) - works in progress (opening date in 2026); section 2 DN1/Corbeanca - DN2/Afumati (19.0km) is open; a 2.3km route on section 3 DN2/Afumati – DN3/Cernica (8.6km) is open, with the remainder scheduled for 2025; section 4 DN3 – A2 (4.47km) is under construction with opening scheduled for Fall 2025.

A1 MOTORWAY (Bucharest - Nadlac)

On A1 section Bucharest - Pitesti is opened to traffic (109.6km). On the following route, Pitesti - Sibiu, sections 1 Sibiu - Boita (13.2km) and 5 Curtea de Arges - Pitsti (30.4km) are open following the opening of route Curtea de Arges - Baiculesti (14.6km) on section 5 in June 2025; works in progress on the other three sections: section 2 Boita - Cornetu (31.3km, opening date in 2028), section 3 (Cornetu - Tigveni, 37.4km, opening date in 2028) and section 4 Tigveni - Curtea de Arges (9.9km, opening date in 2027, but could be opened earlier).

Sibiu ringorad (17.6km) is open to traffic, as are the following sections, Sibiu - Orastie (82.2km) and Orastie - Deva (32.5km). The next section, Lugoj - Deva, is open with the exception of 13.5km on segment 2 (Margina - Holdea) for which works are in progress and the opening date is in 2026 (length of Lugoj - Deva segment which is open: 86.3km).

The other sections on A1, Lugoj - Timisoara (35.1km), Timisoara - Arad and Arad ringorad (41.0km) and Arad - Nadlac (38.9km) are also open to traffic.

A2 SUN MOTORWAY (Bucharest - Constanta)

Entire length open to traffic (202.8km).

A3 TRANSYLVANIA MOTORWAY (Bucharest - Bors)

First section, Bucharest - Ploiesti (65.2km), is open to traffic. On the following section, Ploiesti - Brasov, the only open route is Rasnov - Cristian (6.3km). Section Brasov - Targu Mures was dropped from official plans and was replaced with the A10 Sebes - Turda motorway. The following section, Targu Mures - Gilau (103.5km), is open to traffic.

On the last section, Gilau - Bors, the status is as follows: Gilau - Nadaselu (9.5km) is open; Nadaselu - Mihaiesti (16.8km) is under construction with opening date in 2026; two viaducts on this route, Mihaiesti and Topa Mica (3.2km) are built as a separate project with works in progress and estimated opening date in 2026; Mihaiesti - Zimbor (13.3km) is under construction, opening date in 2026; Zimbor - Poarta Salajului (13.3km) is under construction, opening date in 2026 (Romanasi junction for offloading traffic from the Zimbor - Poarta Salajului route is currently tendered as a separate project); Poarta Salajului - Zalau (15.1km) and Zalau - Nusfalau (25.8km) – contracts signed in April 2025, opening dates scheduled for 2031; Nusfalau - Suplacu de Barcau (13.6km) is open; Suplacu de Barcau - Chiribis (26.4km) - under construction, opening date in 2026; Chiribis - Biharia (28.9km) – under construction, opening date in 2027; Biharia - Bors (5.4km) is open.

A4 MOTORWAY (Constanta Ringroad)

The initial Constanta bypass route of 21.8km is open on its entire length. A tender is in progress for an additional route that starts at the South of Constanta, bypasses some of the Black Sea resorts and ends close to Olimp (30.6km).

A6 SOUTH MOTORWAY (Lugoj - Bucharest)

The only section open to traffic is Balint - Lugoj Ringroad (10.5km). Tenders are in progress for all six sections of route Craiova - Targu Jiu; these cover the route Craiova - Filiasi, 51.5km, which is planned as a motorway, followed by route Craiova - Targu Jiu, which is planned as an expressway, and are split as follows: section 1 DEx12/Ghercesti - Craiova North (10.3km), section 2 Craiova North - Beharca (14.4km), section 3 Beharca - Filiasi (21.7km), section 4 Filiasi - Bibesti (22.9km), section 5 Bibesti - Targu Carbunesti (21.5km) and section 6 Targu Carbunesti - Targu Jiu Ringroad (19.3km).

A7 MOTORWAY (Ploiesti - Pascani)

Segment 1 of section Ploiesti - Buzau, between Dumbrava and Mizil (21,0km) is open (temporary closure for conenction with segment 2); works in progress for segment 2 Mizil - Pietroasele (28.4km, scheduled for opening in Summer 2025) and segment 3 Pietroasele - Buzau (13.9km, scheduled for opening in Fall 2025). Section Buzau - Focsani is open to traffic on almost its entire length (79.0km); the remaining 3.4km on segment 1 Buzau - Vadu Pasii is scheduled for opening in Summer 2025.

On section Focsani - Bacau works are in progress on all three segments: 1 Focsani - Domnesti Targ (35.6km), 2 Domnesti Targ - Racaciuni (38.8km) and 3 Racaciuni - Bacau (21.5km). Opening dates for all three are in 2025. Bacau ringroad motorway is open (16.3km). For section Bacau - Pascani there are works in progress on all three segments: 1 Saucesti - Trifesti Targ (30.3km, opening date in 2025), 2 Trifesti - Gheraiesti (19.0km, opening date in 2025) and 3 Mircesti - Pascani (28.1km, opening date in 2025). Tenders are in progress and contractor is selected for the two segments of section Pascani - Suceava: 1 Pascani - Roscani (33.0km) and 2 Roscani - Suceava Aiport (29.0km); contracts for these two segments have not been signed yet. Tenders are planned for route Suceava - Siret which will consist of a motorway for route Suceava - DN2H and an expressway for route DN2H - Siret Border.

A8 UNION MOTORWAY (Tg. Mures - Ungheni)

Section I Targu Mures - Miercurea Nirajului (24.4km) is under construction with opening date in 2026. On section II Miercurea Nirajului - Leghin execution contracts are signed for segments 1b Miercurea Nirajului - Sarateni (23.4km) with opening scheduled for 2027, 2a Ditrau - Grinties with opening scheduled for 2029 and 3c Pipirig - Vanatori Neamt/Leghin (19.3km) with opening scheduled for 2029; tenders in progress for the remaining three segments: segment 1c Sarateni - Joseni (32.4km), with contractor selected, 1d Joseni - Ditrau (14.4km) and 2b Grinties - Pipirig (34.1km).

Section III Leghin - Targu Neamt (29.9km) is under construction with opening date in 2026. On route Targu Neamt – Iasi – Ungheni there are tenders in progress for all five segments: 1 Targu Neamt/Motca - Targu Frumos (27.0km), 2 Targu Frumos - Letcani/DN28 (22.6km), 3 Letcani/DN28 - Iasi/DN24 (17.7km), 4 Iasi/DN24 - Golaiesti (12.7km) and 5 Golaiesti - Border/Ungheni Bridge (2.8km). A bridge over Prut river at Ungheni (1.1km) is under construction with opening date in 2026.

A9 MOTORWAY (Timisoara - Moravita)

There are tenders in progress for the first two sections of this motorway: Remetea Mare - Jebel (35.7km) and Jebel - Moravita (33.5km).

A10 MOTORWAY (Sebes - Turda)

Motorway opened to traffic on its entire length.

A13 MOTORWAY (Sibiu - Bacau)

Contracts signed for all four sections of Sibiu - Fagaras route with opening dates in 2027 (possibly delayed to 2018): section I Boita - Avrig/Marsa (14.3km), section II Avrig/Marsa - Arpasu de Jos (19.9km), section III Arpasu de Jos - Sambata de Sus (17.6km), section IV Sambata de Sus - Fagaras (16.3km).

A14 NORTH MOTORWAY (Oar - Suceava)

Tender in progress for Oar – Satu Mare expressway (10.8km) with contractor selected; the procedure was challenged and the contract is not yet signed.

DEx4 EXPRESSWAY (Turda - Dej)

Works in progress on section A3 - DN1 (Tureni), 5.0km, opening date in Summer 2025.

DEx5A EXPRESSWAY (Bacau - Piatra Neamt)

Tender in progress for the Bacau - Piatra Neamt Expressway (51.0km).

DEx6 EXPRESSWAY (Focsani - Galati) AND BRAILA BRIDGE

Works in progress for route Braila - Galati (12.3km). Opening is scheduled for Fall 2025. The route connects to a bridge over the Danube between Braila and Smardan in Tulcea County which was opened in July 2023 (the bridge is not part of the Braila - Galati expressway). There is a tender in progress for route Focsani - Braila (73.5km): section 1 Focsani/A7- Maicanesti/DN23 (28.2km), section 2 Maicanesti/DN23 - Silistea/DJ221C (37.6km) and section 3 Silistea/DJ221C - Braila - DEx6 (7.7km).

DEx12 EXPRESSWAY (Craiova - Pitesti)

The following sections are open: section I Craiova - Robanesti (17.7km), section II Robanesti - Slatina (39.9km) and section III Slatina - Colonesti (31.8km); section IV Colonesti - Pitesti (31.9km) is partially open on 19.0km, between Colonesti and Albota, with the remainder scheduled for opening in Summer 2025.

DEx16 EXPRESSWAY (Arad - Oradea)

A section between Oradea and A3 motorway (at Bors) is open; out of a total of 19.0km for this route, 13.0km are built as an expressway and the remainder as a national road. For the route Arad – Oradea (120.5km) the status is as follows: execution contract signed for section 1 Oradea - Salonta (33.7km + connecting road); tender in progress for section 2 Salonta - Chisineu Cris (39.7km + connecting road); tender in progress and contractor selected for section 3 Chisineu Cris - Arad (47.1km + connecting road).

A section of 3.5km between A1 motorway at DN7 at Arad, designated A11, is open to traffic.

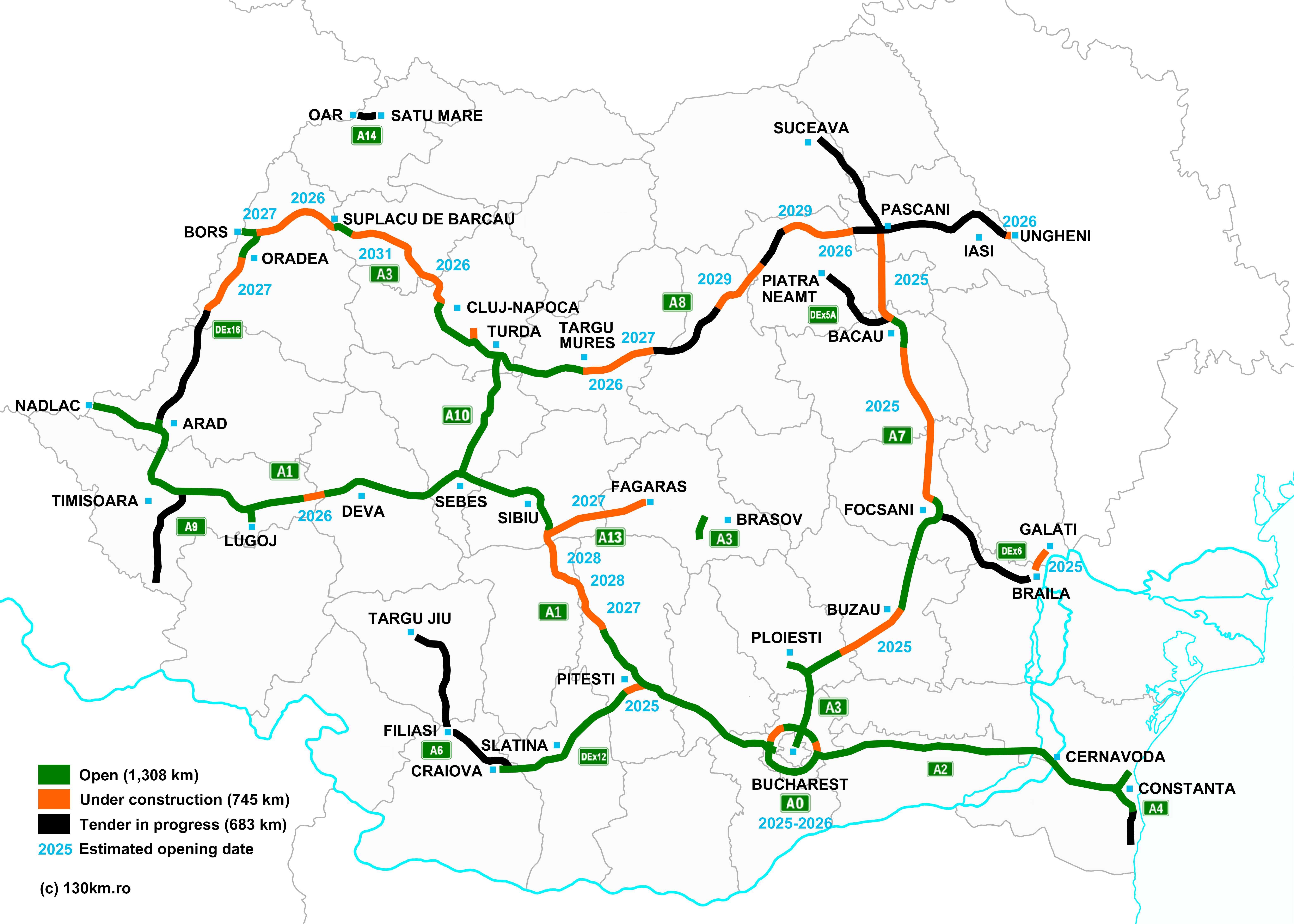

The map of Romanian motorways and expressways which are open, under construction or are being tendered at the end of Q2 2025 is shown below (click to enlarge):
